ITPM - 11. Project Risk Management

Importance of Project Risk Management

  • General Definition of a project risk : an uncertainty that can have a negative or positive effect on meeting project objectives
  • Managing negative risks involves a number of possible actions that project managers can take to avoid, lessen, change, or accept the potential effects of risks on their projects.
  • Positive Risk : investing in opportunities
  • 프로젝트 선택 및 범위 결정, 현실적인 스케줄 및 비용 추정 설계에 긍정적인 영향을 미친다.

Risk and Personal Utility

  1. Risk-averse(risk hater)
  2. Risk-seeking(risk prefer)
  3. Risk-neutral(don't care)
  • Risk Utility : amount of satisfaction or pleasure received from a potential payoff(reward)

  • (Realized) Crisis Management VS (Potential) Risk Management
    - Resolving a crisis has much greater visibility, often accompanied by rewards from the top management (가시성이 크고, 보상 및 칭찬 받기 쉬움)
    • 반대로, risk management는 effective하다. 문제 발생이 줄어들고, 발생하더라도 심각도가 줄어든다. (효과적인 경우 오히려 티가 안 남)

Best Pratice: 좋은 리스트 과리는 위험을 줄이는 데 그치지 않고, 기회를 인식하고 전략적으로 활용하는 것까지 포함되어야 하며, 조직 내 모든 계층의 참여와 지원이 필수적이다.


Process Group

  1. Plan Risk Management
  2. Identify Risks
  3. Perform Qualitative Risk Analysis -> prioritizing
  4. Perform Quantitative Risk Analysis -> numerically estimating the effect
  5. Plan Risk Response -> preparing action plan
  6. Implement Risk Responses
  7. Monitor Risks

1. Plan Risk Management

Outputs

  • Risk Management Plan

Additional Plans

  1. Contingency Plans : Plan B -> Identified risk event occur 시에 수행 계획
  2. Fallback Plans : Plan C -> if attempts to reduce the risk are not effective 일 경우 수행 계획
  3. Contingency Reserves or Allowances (비상 예산 및 허용치) : cost baseline에 포함된 식별된 리스크에 대한 비상 예산
  4. Management Reserves :식별되지 않은, Unknown risks에 대한 예산

Common Sources of Risk on IT Projects

  1. Market Risk : Will it be useful to the organization or marketable to others?
  2. Financial Risk : 비용을 감담할 수 있는가?(afford to undertake the project)
  3. Technology Risk : Technically feasible
  4. People Risk : 역량을 가진 인력이 있는가
  5. Structure / Process Risk : 프로세스를 갖추고 있는가, 조직과 업무에 얼마나 큰 변화를 주는가

2. Identifying Risks

Output

  • Risk Register
  • Risk Report

Tool

  • Braingstorming
  • The Delphi Technique
  • Interviewing
  • SWOT Analysis

Risk Register Component

  1. Number of ID
  2. Rank
  3. Name
  4. Description
  5. Category
  6. Root Cause
  7. Triggers
  8. Potential Response
  9. Risk Owner
  10. Probability
  11. Impact
  12. Status

Risk Report

  • Summary information on risk register

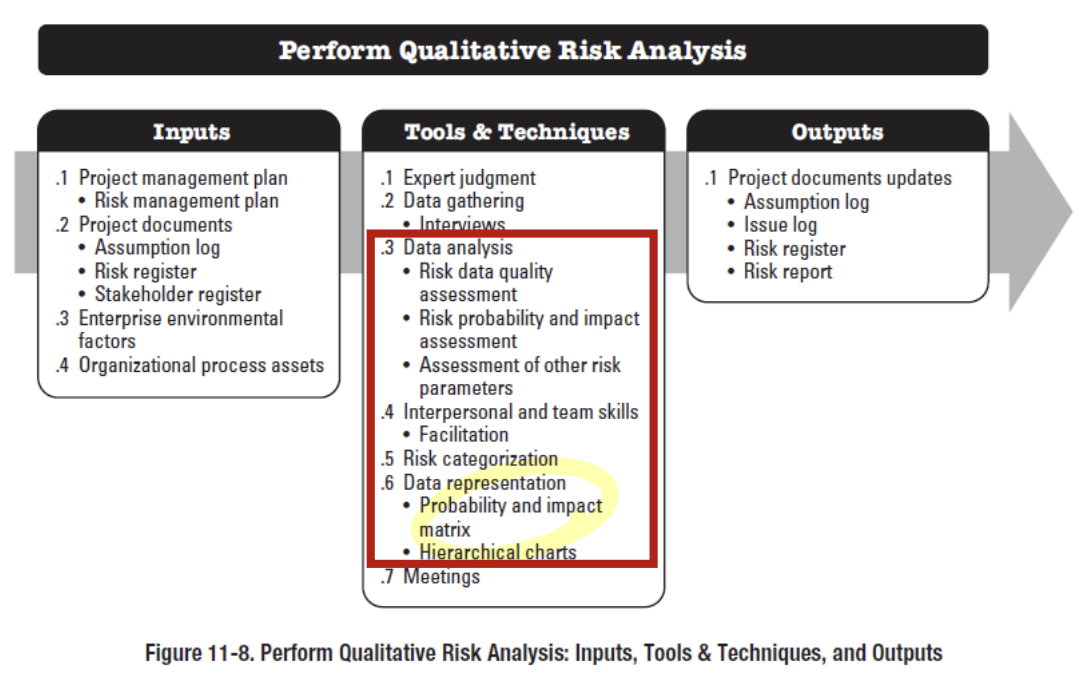

3. Performing Qualitative Risk Analysis

Tools

  • Probability and Impact matrix
  • The Top Ten Risk Item Tracking
  • Expert Judgment

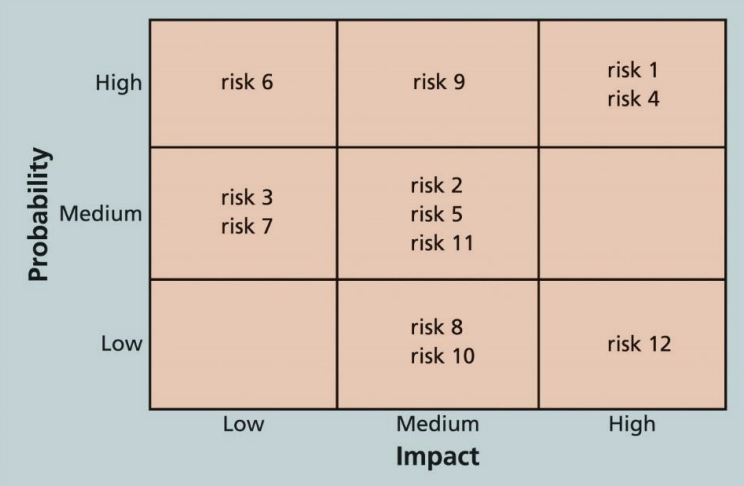

Probabilit and Impact matrix

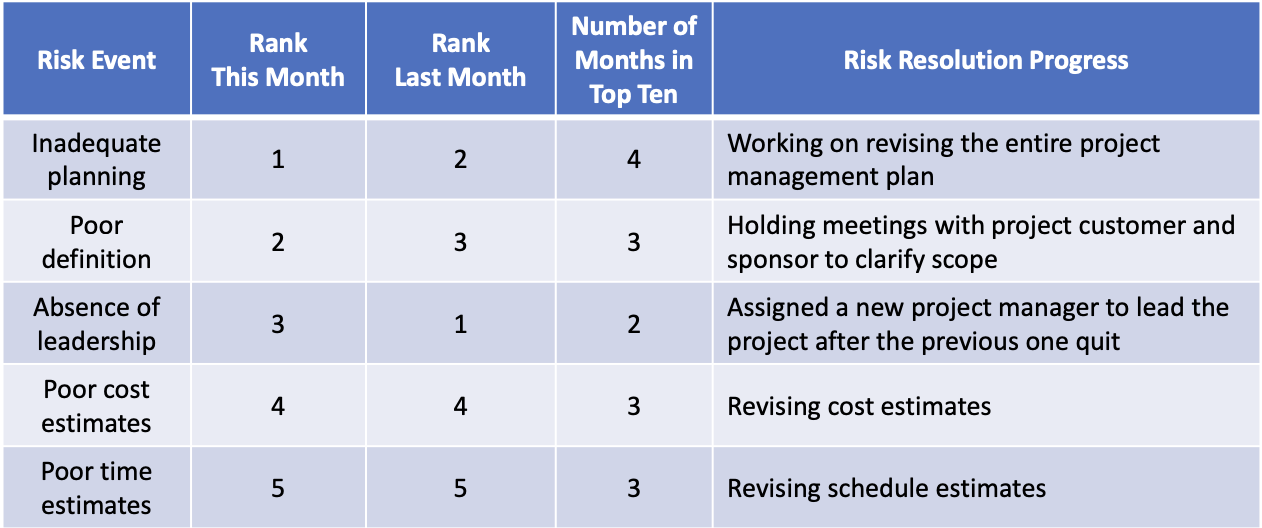

Top Ten Risk Item Tracking

  • Periodic Review : 상위 10개 위험 주기적으로 검토
  • Component
    - Name
    • Rank in This month
    • Rank in Last month
    • Number of Months in Top Ten
    • Risk Resolution Progress (위험 항목 해결을 위한 진행 요약)
  • Watch list : a list of risks that are low priority, but are still identified as potential risks

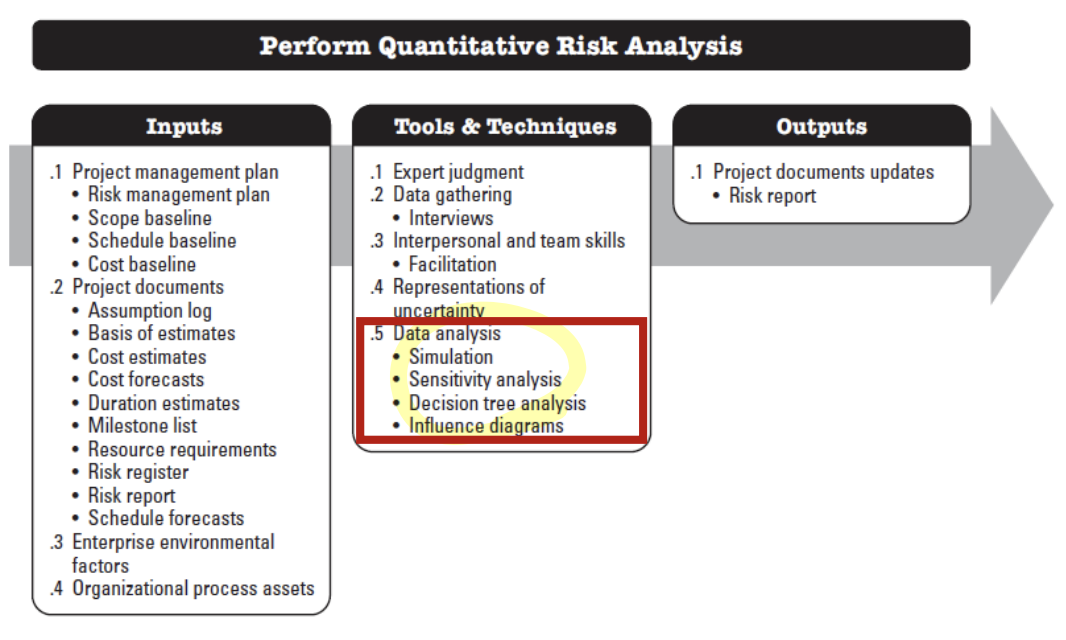

4. Performing Quantitative Risk Analysis

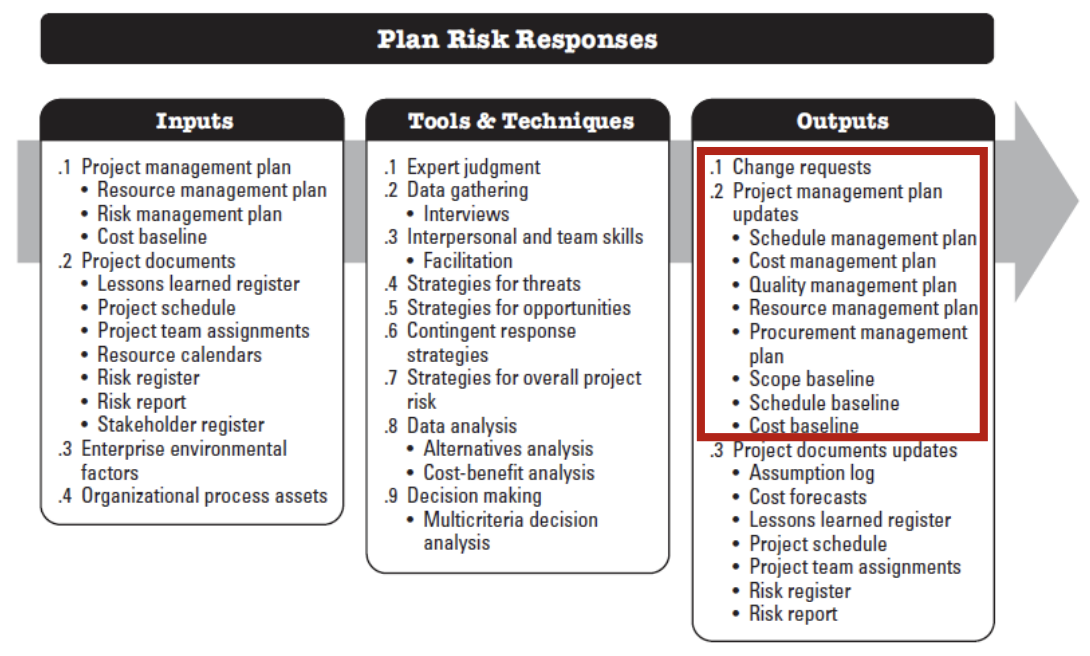

5. Planning Risk Responses

Output

  • Change Requests
  • Project Management Plan Updates
    - Schedule Management Plan
    • Cost Management Plan
    • Quality Management Plan
    • Resource Management Plan
    • Procurement Management Plan
    • Scope baseline
    • Schedule baseline
    • Cost baseline

Basic Reponse strategies for negative risks

  • Risk Avoidance
  • Risk mitigation
  • risk acceptance
  • risk transference
  • risk escalation

Basic Reponse strategies for positive risks

  • risk exploitation
  • risk enhancement
  • risk acceptance
  • risk sharing
  • risk escalation

Identify residual and secondary risks

  • Residual Risk (잔여 위험) : 대응 전략을 모두 실행한 이후에도 남아 있는 리스크, 위험을 줄이기 위해 백업 시스템을 마련했지만 여전히 장애 발생 가능성이 존재

  • Secondary Risks (2차 위험) : 위험 대응 조치의 직접적인 결과로 새롭게 생겨나는 위험, 백업용 서버를 추가했는데 이 서버의 보안 위험이 발생


6. Implement Risk Responses

Output - Change Requests, Project Documents updates


7. Monitoring Risks

  1. 위험 대응 조치가 제대로 수행되고 있는지 확인
  2. 계획된 risk response가 실제로 실행되었는지 체크
  3. 식별된 위험 추적
  • 등록된 위험이 발생했는지, 상태가 어떻게 바뀌었는지 지속적으로 관리
  1. 새로운 위험 식별 및 분석
  • 프로젝트가 진행되며 새로운 위험이 나타날 수 있음 → 이를 식별하고 분석해야 함
  1. 위험 관리 활동의 전체적인 효과성 평가
  • 지금까지 위험을 얼마나 잘 관리해왔는지 점검

💡 요점: "위험 관리는 초기 분석에서 끝나는 것이 아니다!"
